TEXSA Waterproofing Systems
Roofing & Waterproofing

Combo Roof System Failure Analysis

Leakage, membrane debonding, trapped moisture, ponding-induced degradation and thermal-movement cracking.

Sector
Roofing & Waterproofing
System
Combo / Hybrid Roof Waterproofing System
Failure mode
Leakage, membrane debonding, trapped moisture, ponding-induced degradation and thermal-movement cracking.
Status
Published case
01 — Root cause

What actually failed

Combo roof systems combine a primary waterproofing membrane (bituminous or liquid-applied), a thermal insulation layer, a protection / screed layer and the structural deck. In UAE conditions — high surface temperatures, daily thermal cycling, summer humidity and occasional intense rainfall — small detailing or material-compatibility errors compound quickly. The most common observed root cause is not a single defect but a combination: incompatible adhesion between layers, blocked drains creating long-term ponding, and trapped construction or service-water moisture that cannot escape because the vapour path was sealed shut on both sides. Once the membrane lifts at upstands, parapets or penetrations, water tracks horizontally between layers and surfaces metres away from the actual breach — which is why visible leak points rarely match the failure point.

02 — Symptoms

What the asset is showing

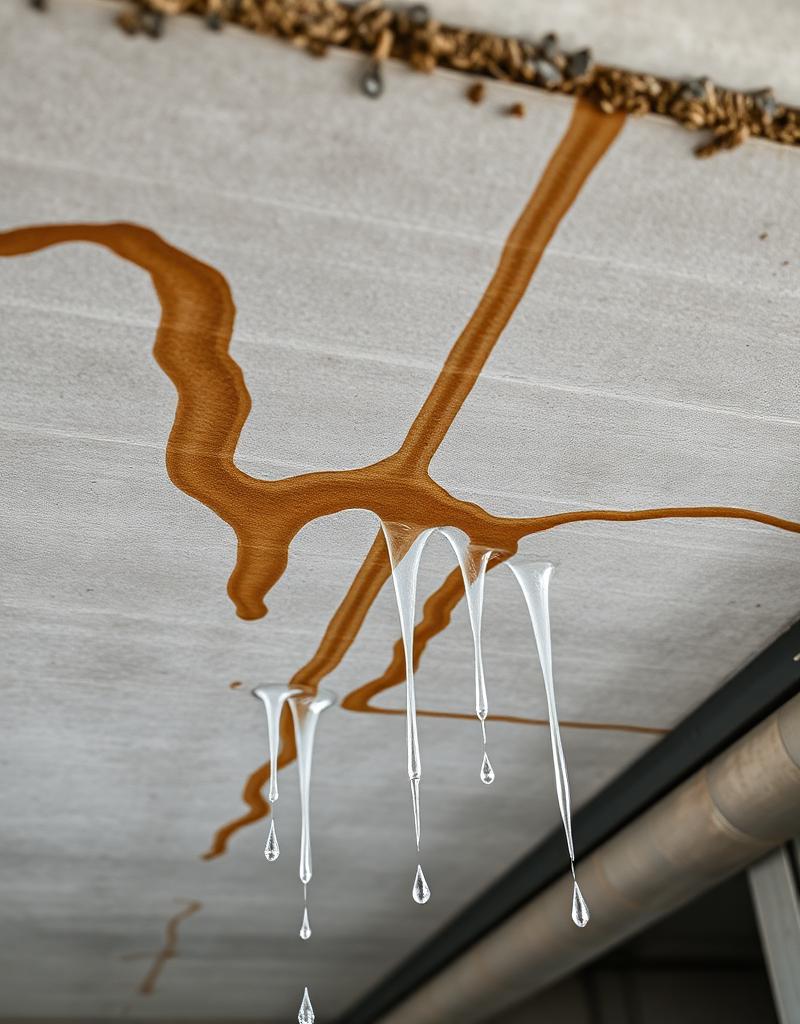

Active water leakage and salt staining on a concrete soffit
Evidence 02.1

Active interior leakage

Damp patches, staining or active dripping below the slab, often appearing far from the visible breach because water tracks laterally between layers.

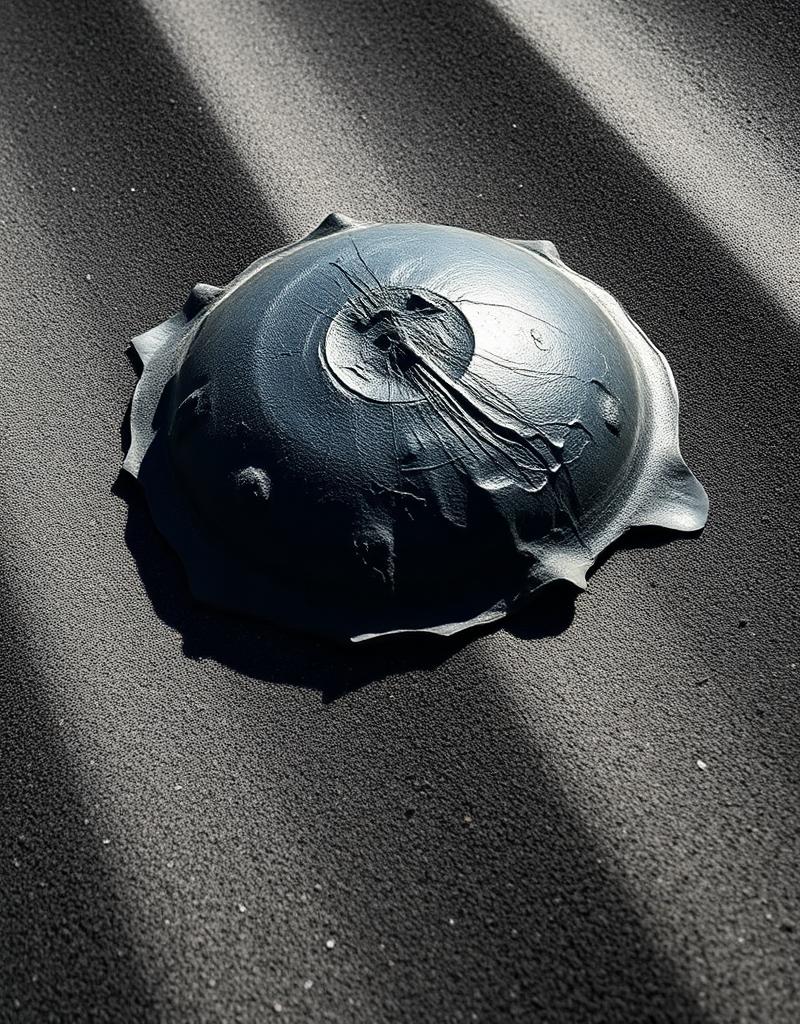

Large blister forming in a bituminous waterproofing membrane under peak heat
Evidence 02.2

Membrane blistering and lifting

Soft, raised bubbles across the field or at laps caused by trapped moisture or vapour pressure under the membrane in peak afternoon heat.

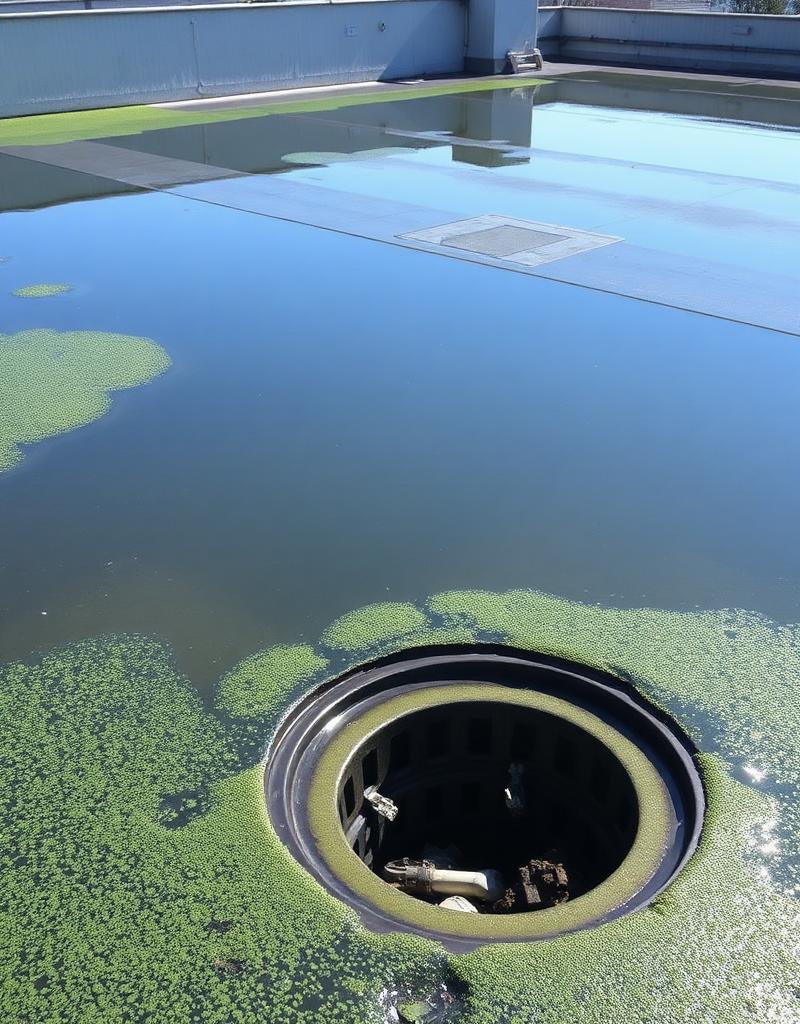

Ponding water and algae growth around a blocked roof drain
Evidence 02.3

Standing water (ponding)

Water that does not drain within 48 hours after rain or wash-down, accelerating membrane breakdown and biological growth.

Cracking at a roof parapet upstand and pipe penetration detail
Evidence 02.4

Cracking at upstands, parapets and penetrations

Hairline or open cracks where movement, poor termination detailing or missing reinforcement strip concentrates stress.

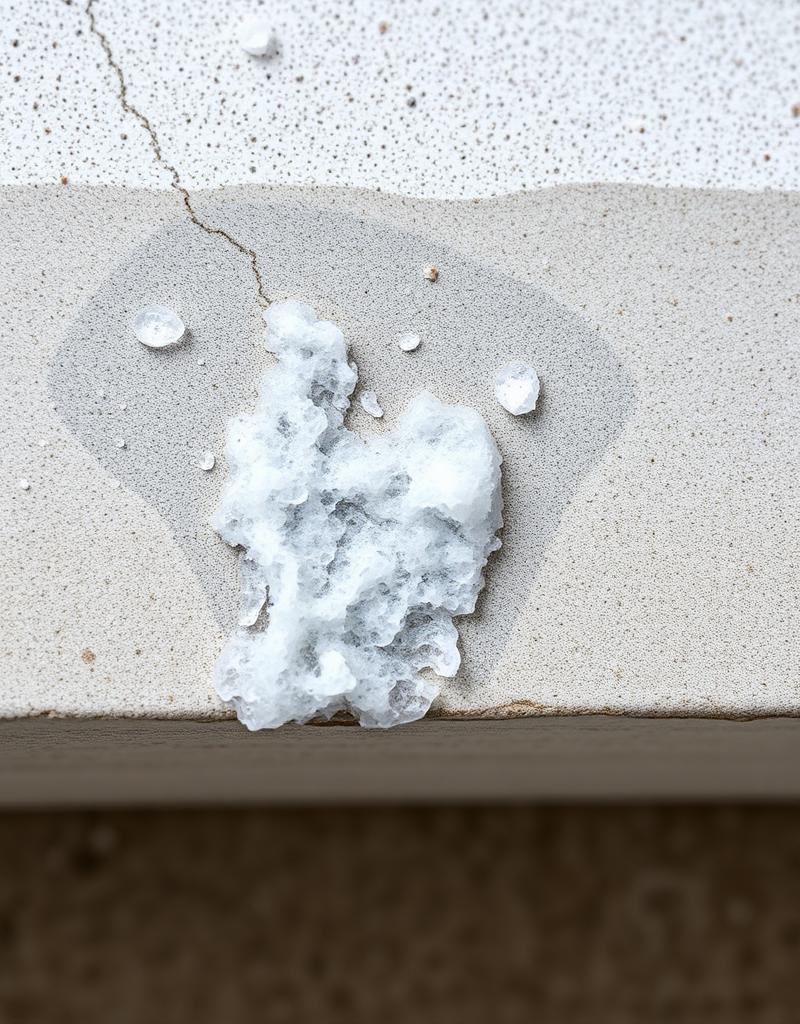

White crystalline efflorescence on a concrete soffit indicating moisture migration
Evidence 02.5

Efflorescence and salt staining

White deposits on screed or soffit indicating moisture migration through the slab and dissolution of cementitious minerals.

Core sample showing saturated insulation between membrane and concrete deck

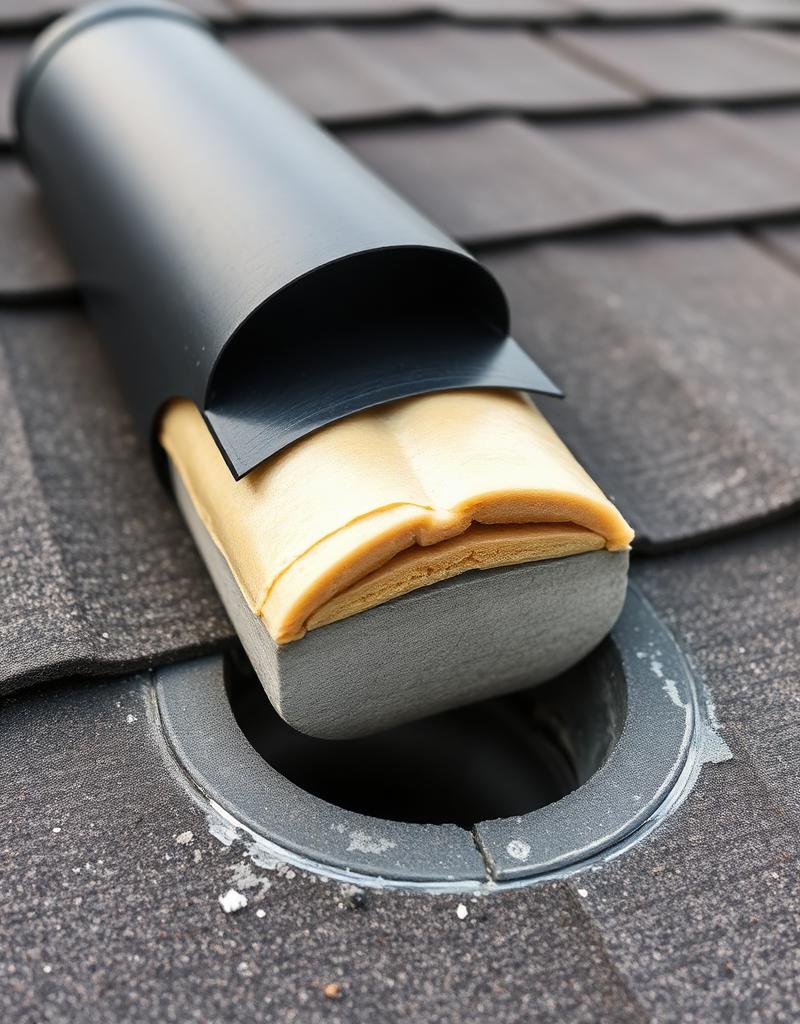

Evidence 02.6

Soft, spongy or wet insulation

Detected during core sampling or moisture survey — confirms the system has lost its thermal performance and is feeding the leak.

03 — Diagnosis

How we confirmed it

  1. 01

    Visual and detail survey

    Systematic walk-down of field, upstands, drains, expansion joints and penetrations. Photograph and mark every suspect detail before any disturbance.

  2. 02

    Moisture mapping

    Non-destructive capacitance or impedance scanning across the deck to plot wet zones and isolate them from sound areas.

  3. 03

    Infrared thermography

    Early-morning or post-sunset thermal imaging to reveal trapped moisture as cooler signatures relative to dry insulation.

  4. 04

    Core sampling

    Targeted cores through suspect zones to confirm the build-up, layer condition, adhesion and the presence of wet insulation.

  5. 05

    Adhesion pull-off testing

    ASTM D4541 pull-off on the existing membrane and on trial primer/coating patches to confirm overlay compatibility before specification.

  6. 06

    Flood test or electronic leak detection

    Where safe, controlled flood test per ASTM D5957; otherwise low-voltage or high-voltage electronic leak detection (ASTM D7877 / D8231) to pinpoint discrete breaches.

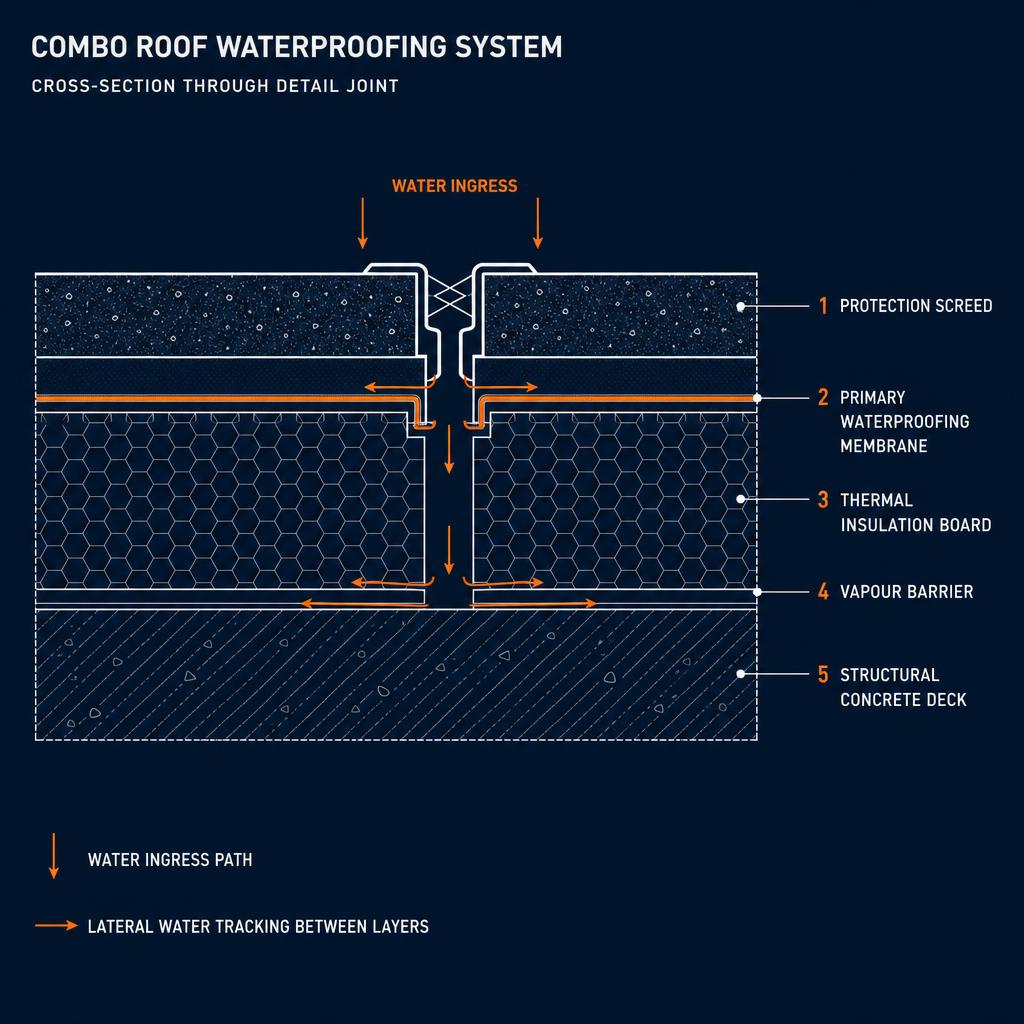

Combo roof waterproofing system cross-section showing water ingress paths and lateral tracking between layers
Fig 3.1 — Cross-section through a detail joint showing how water bypasses the primary seal and tracks laterally between layers.
04 — Remediation

How we put it back in service

  1. 01

    Isolate and remove unsalvageable build-up

    Cut out and dispose of saturated insulation and delaminated membrane down to a sound, dry substrate verified by moisture readings.

  2. 02

    Substrate preparation

    Mechanical grinding or shot-blasting to ICRI CSP 3–4 profile, repair of cracks and honeycombs, and reinstatement of correct falls where ponding was identified.

  3. 03

    Primer and detail strip

    Apply the system-specific primer with verified adhesion, followed by reinforced detail strips at all upstands, drains, penetrations and movement joints.

  4. 04

    Spray-applied polyurea overlay

    Hot, plural-component pure polyurea applied to the specified DFT in a single monolithic, seamless layer — fast-curing, fully bonded, high elongation, and tolerant of UAE thermal cycling.

  5. 05

    Termination and protection

    Mechanical or chemical termination at edges, parapets and metal flashings; UV-stable top-coat where exposed; protection layer or paver re-installation where trafficked.

  6. 06

    QA/QC sign-off

    Wet-film and dry-film thickness checks, spark testing for pinhole detection, adhesion pull-off witness samples, and full photographic close-out report.

05 — Prevention

How to stop it recurring

  1. 01

    Correct falls and drainage

    Verify minimum 1:80 fall to drains at design stage and after any overlay; never accept ponding as in-service condition.

  2. 02

    Compatible system specification

    Specify one engineered system from primer to top-coat from a single manufacturer — do not mix incompatible bituminous and reactive systems without a tested interlayer.

  3. 03

    Detailing at every transition

    Reinforced detail strip at every upstand, drain, expansion joint and penetration — these are where >80% of combo roof failures initiate.

  4. 04

    Construction-phase moisture control

    Do not encapsulate a wet substrate. Verify moisture content before priming; protect work-in-progress from rain and condensation.

  5. 05

    Planned inspection regime

    Annual visual inspection, drain clearing before and after the rainy season, and a 5-year condition survey with moisture mapping before warranty expiry.
